Interstate 95
Vietnam Veterans Memorial Highway


The major north-south highway along the East Coast, Interstate 95 was originally planned by the City of Philadelphia as a link between the Port of Philadelphia, downtown, and points northeast.  In 1937, engineers from the city's planning commission proposed an elevated highway from Delaware Avenue to Center City.  The plan was rejected due to the findings that the support columns would interfere with port operations.  In 1945, Department of Highways engineers reviewed the plans, and two years later both the Bureau of Public Roads and the Philadelphia City Planning Commission approved the path of the expressway.  Original price tag for construction was $180 million and would have been complete by 1960.

Early in the planning stages, the project was studied as a potential toll highway to pay for construction.  The highway was to be built as the Philadelphia Loop Extension and become a part of the Pennsylvania Turnpike Commission's plan for a statewide system of limited-access toll highways. However, on June 29, 1956 when the Interstate Act was passed, the project was handed back to the then Department of Highways.

Originally, Pennsylvania wanted to route I-95 along the US 13 corridor, leaving the current one at Exit 40.  New Jersey did not like this routing on the basis that it would overtax the four-lane Trenton Toll Bridge and Trenton Freeway.  The states studied three alternatives for a crossing:  Scudder Falls west of Trenton, the existing Trenton Toll Bridge, and Biles Island to the east of Trenton.  The two states approved the Scudder Falls crossing in 1960 and the Bureau of Public Roads approved the new alignment of I-95 in 1964.   This is why a direct connection between the Pennsylvania Turnpike and the Interstate was not constructed.

The first section to open was the 1,740 foot-long Scudder Falls Bridge between Pennsylvania and New Jersey.  Construction began on August 8, 1958, but the $ 2,286,610.40 bridge would not open to traffic until June 22, 1961 due to incomplete approaches on both sides of the bridge.  The bridge is not tolled itself, but instead relies on the funds from the other bridges under the Delaware River Joint Toll Bridge Commission jurisdiction for support.

Construction began in 1962 on two sections:  from Exit 2 to US 13 near the current Exit 7 and from Exit 35 to Exit 40.  These first two sections of Interstate 95 opened in 1965.

Controversy began to brew in 1961 as the Interstate's future route was being planned into Center City.  The 1955 report from the engineering firm of Madigan-Hyland called for a six-lane elevated highway through this area, but later changed to an eight-lane design in 1959.  The project would encompass urban renewal with the demolition of empty warehouses for the Interstate and the Penn's Landing development.  In 1963, upon seeing a model of the elevated expressway through the proposed Penn's Landing development, architect Frank Weise got a hold of Edmund Bacon, the chief planner at the city planning commission, and warned him that the expressway would sever the link between the city and the river.  Weise created a team to find alternate designs and submitted their findings to the Department of Highways.  Highway officials tapped the design firm Ammann and Whitney to design an eight-lane depressed expressway, two years after Weise and his team began developing alternate designs.  To ensure this section wouldn't become an eyesore, the City Council sought and ultimately obtained Interstate highway funds to implement the Ammann and Whitney design, which was today's Penn's Landing.

In 1965, construction commenced on the section from just south of Exit 32 to Exit 35 and opened the following year to traffic.  In 1967, construction began on the section from the Delaware state line to Exit 2 and from Exit 23 to Exit 32.  In 1968, construction concluded on the section from Exit 25 to Exit 32.  That same year, work on the Interstate moved to the suburbs, as construction commenced on the section from Exit 46 to the Scudder Falls Bridge in Bucks County.  In 1969, the section from the Delaware state line to Exit 2 opened, while construction began around Exit 9, between Fort Mifflin and Exit 17, and from Exit 40 to Exit 44.

1968 Clearing Operations
Clearing for the I-95 alignment in 1968.  (Philadelphia Inquirer)

In 1970, the section from Exit 46 to the Scudder Falls Bridge opened to traffic as did the section from Exit 23 to Exit 25.  In 1973, the section from Exit 40 to Exit 44 opened to traffic and construction was extended from near Exit 7 to near Exit 9.  The following year, the section around Exit 9 opened to traffic, which extended from Exit 8 to Exit 10 and included the ramps to and from PA 291.  In 1974, construction also continued on the section near the Naval Shipyard from Exit 15 to Exit 20.  In 1975, the section from Exit 7 to Exit 8 opened to traffic and construction began on the sections not already underway between Exit 10 and Exit 23 which included the double-deck Girard Point Bridge.  This meant that I-95 was either open to traffic or under construction through the Commonwealth.  In 1976, a two mile section between Enterprise Avenue and Broad Street opened.  In 1977, the section between Broad Street and the Schuylkill Expressway/Walt Whitman Bridge interchange opened.

The 1980s began with the 10 mile section from Exit 13 to Exit 23, which passed right through downtown Philadelphia and under Penn's Landing where the USS Olympia is docked, opening to traffic.  The remaining four-mile section between Exit 10 and Exit 13 would seem like a cake-walk to finish; however, engineering, environmental, and fiscal problems would befall this part.  The engineering and environmental problems were with the city's water supply, which is separated from the sludge discharge by the sewage treatment plant by a layer of clay.  Engineers were faced with a dilemma of having to pierce the clay with support pilings, and not contaminate the city's water supply.  It was remedied with workers inserting a cylinder partway into the clay, and removing the sludge from inside.  With the inside of the cylinder cleaned out and sealed, it was safe to insert the pilings into the clay.  The financial problems were due to the Pennsylvania legislature voting down implementation of an emission program in 1981.  In reaction, the Federal government suspended highway funds for projects within the Commonwealth which did not impact I-95 construction immediately, but would have affected continuation of the construction.  Pennsylvania began emission testing in 1983 and thus regained highway funds for projects.

View from Penn's Landing
View of Interstate 95 from Penn's Landing.  (Alex Nitzman)

The section finally opened, and thus completed Interstate 95 in Pennsylvania on December 15, 1985.  This section includes collector-distributor highways on the outside of I-95 to serve Philadelphia International Airport and ramps leading to Island Avenue.  The entire Interstate cost more than $500 million to build, with $191 million of that being spent on that final section alone.

In the late-1980s, PennDOT opened previously constructed ramps for the Crosstown Expressway at Exit 20.  Originally, they were planned to connect I-95 to I-695 and were built even after it was removed from state plans in 1974.  Residents feared that the ramps would lead to a revival of the expressway plans, but in 1982, PennDOT reached a compromise with community leaders which cleared the way for connections to surface streets.

On March 13, 1996, a fire broke out under the elevated section between Westmoreland Street and Tioga Street which caused three spans of the 26-span, 1,707-foot-long Westmoreland Viaduct to buckle and forced PennDOT to close Interstate 95.  US 1 took most of the brunt of the detoured vehicles. The cause of the fire was discarded tires in an illegal dump underneath the viaduct. Temporary spans were constructed to carry the Interstate traffic, and within weeks, the damaged section was replaced with costs running into the millions.

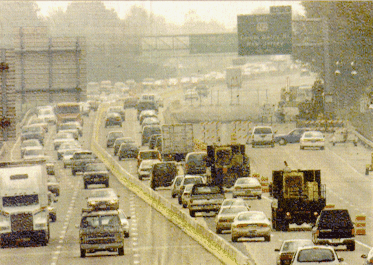

Fire also played a role in the history of the highway only a mere two years later.  On May 23, 1998, the driver of a tanker truck loaded with 8,700 gallons of gasoline, while swerving to avoid a passing car, jumped the Jersey barrier and exploded after striking a pickup truck in the southbound lanes.  The drivers of both vehicles died at the scene.  Nine steel support girders, each six feet in length, eight inches tall, and between 65 and 80 feet long of the bridge crossing the Chester Creek were damaged.  During five weeks, PennDOT spent $3.5 million to rebuild the bridge and open it in time for the Independence Day weekend.

Bridge Accident
Chester Bridge accident (Pittsburgh Tribune-Review)

For the Northeast, the summer of 1999 was not a pleasant one.  It was so hot on July 5, the southbound lanes near the Street Road Exit buckled.  Then if that wasn't bad enough, a 10 inch-high heave was discovered by PennDOT workers on the northbound lanes at the same exit on July 6.

I-95/PA TPK InterchangeThe completion of Interstate 95 between Philadelphia to New York City is inching ever closer with construction of the I-95/PA Turnpike interchange. Upon completion, I-276 will end at another Interstate rather than disappearing at the Pennsylvania/New Jersey border.  Until the late 1960s, I-95 followed the US 13 alignment in the area.  It would have provided a direct connection to the Turnpike, but because of environmental reasons the Interstate could not be built north of the Turnpike.

Stage One involves building a high-speed interchange between the Pennsylvania Turnpike and Interstate 95, a new mainline toll plaza, and widening the Turnpike from Exit 351 to the Delaware River.  Stage Two will involve constructing a parallel span across the Delaware River south of the existing span.  The projected completion date is 2016 for both stages, but the interchange is expected to be completed sooner.  The following are the plans for the new toll plaza, interchange, and bridge:

Modified Toll Plaza West
Modified Toll Plaza West will be built west of I-95 to allow free-flowing traffic
between the Turnpike and I-95.  The plaza will consist of 18 lanes and be located
behind the Philadelphia Park Racetrack.   (Pennsylvania Turnpike Commission)



Single Loop A Interchange
Single Loop A Interchange will link
the Turnpike and I-95 where they
currently cross.
(Pennsylvania Turnpike Commission)



Bridge Proposal
Delaware River Bridge South will be located 75 to 100 feet south of the existing
bridge and feature three lanes for carrying New Jersey-bound traffic.  The current
span will be rehabilitated and be reconfigured for three lanes for westbound
traffic.  The current Delaware River Bridge toll plaza will be modified as a
westbound-only facility.   (Pennsylvania Turnpike Commission)

On January 6, 2004, the US Department of Transportation approved the environmental impact study.  "Late 2007" was the "optimistic forecast" for groundbreaking for the first part, a new toll plaza, said PTC spokeswoman Christina Hampton after the announcement was made.  However, it would be six years later when PTC CEO Mark Compton joined Governor Tom Corbett and Lieutenant Governor Cawley as well as federal, state, and local officials at the Turnpike's Trevose Maintenance Facility, where the mainline toll plaza will be built, in Bensalem on July 30, 2013 to officially kickoff the start of the $500 million Stage 1 of the project.  "We’re here to commemorate the beginning of a critical infrastructure project that will undoubtedly improve the quality of life for residents and commuters in the surrounding area," said Turnpike Chief Executive Officer Mark Compton.  "Many also consider the Turnpike/I-95 link to be a central component for the continued economic growth and competitiveness of this region."  This phase is projected to be completed in 2018.  Project website:  http://www.paturnpikei95.com/

Current I-276/I-95 crossing at the left and conceptual drawing of the future I-276/I-95 interchange
Current I-276/I-95 crossing on the left and conceptual drawing of the future I-276/I-95
interchange on the right.  (Pennsylvania Turnpike Commission)

An unusual financing scheme to complete the interchange came to light in April 2013.  Foreign investors, primarily from China, would infuse the project with $200 million, and in turn, they would get green cards for themselves and their families.  The deal involves creating a new limited partnership called the Delaware Valley Regional Center Pennsylvania Turnpike L.P., with an office in Berwyn, that would have to be approved as a US Citizenship and Immigration Service designated "regional center" to recruit foreign investors with which to provide the Turnpike Commission the loan.  On April 26, the PTC signed a $200 million loan agreement with the limited partnership.  Federal law permits the dealmakers to go immediately to China, or elsewhere, to begin recruiting investors, but they can not accept funds until approval.  Despite some success around the country with these type of partnerships, the Immigrant Investor Program has drawn criticism for lax oversight and dubious projects that have not produced domestic jobs nor permanent green cards for foreign investors.

PennDOT rebuilt a section of I-95 between Spruce Street and I-676 through the Penn's Landing tunnel.  The $9.7 million project included work performed on the southbound in 1999 and concluded with the work northbound lanes in June 2000. The project entailed removing 13 inches of the old concrete pavement and replacing it with a new concrete surface. Also included was the removal of old wall tiles from inside the tunnel, painting the walls with anti-graffiti coating, and diamond grinding the new concrete to give motorists a smooth riding surface.

Entering the 21st Century, work to improve Interstate 95 continued with an ambitious program totaling $500 million.  The project will include the rebuilding of bridges, installing Intelligent Transportation System (ITS) equipment, and upgrading several interchanges.  Project website:  http://www.95revive.com/.



95revive map
Extent of the 95revive project
(PennDOT)



Installing a variable message sign
Installation of a variable message sign. (PennDOT)

New access ramps to Philadelphia International Airport are also a part of the 95revive plan.  The $86.5 million project included:  construction of new ramps from northbound and southbound I-95 to the new Departures Terminal and the removal of the current ramp from southbound I-95 to the current Departures Terminal, construction of a new ramp from northbound I-95 to the current Arrivals Terminal, construction of nine, Mechanically Stabilized Earth (MSE) retaining walls, relocation of the Bartram Avenue ramp to southbound I-95 and repaving of Bartram Avenue between Island Avenue and PA 291, relocation of the northbound I-95 collector-distributor highway at the airport, creation of replacement wetlands, and placement of new signs and sign structures in the airport property.  Construction concluded on June 28, 2002.

Setting piles for the new ramp

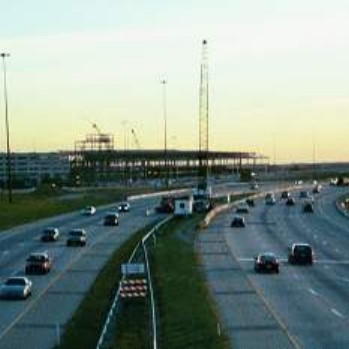

Pile driver setting the footing for supports for the
new access ramps.  The new terminal is under
construction in the background.  (PennDOT)


Beam placement for the new ramp
Beams being place for the deck of the new ramp.
(PennDOT)

On May 3, 2001, PennDOT announced that on May 17 it would start a two-year, $42.6 million dollar project to rebuild bridges on Interstate 95 at the Allegheny Avenue and Bridge Street interchanges.  The first structure to be rehabilitated was the Westmoreland Viaduct begun in July 2001.  The project consisted of rebuilding the 26-span structure by replacing piers, beams, and sections of the bridge deck.  Work moved to the bridge at Allegheny Avenue in Summer 2001, where crews replaced expansion joints, repaired bridge walls, replaced concrete approach slabs, and repaired beams.  Also, the Richmond Street Viaduct, from Lehigh Avenue to Ann Street, had old paint removed from the support beams and a new coat of paint placed on the beams.  In Spring 2002, work shifted to the bridge over Levick Street to replace the beams and deck.  All work was completed by November 2002.

In late 2002, PennDOT began Phase Three of the 95revive project which included rehabilitating six bridges in a three mile section between Cottman Avenue and Academy Road, resurfaced 1.2 miles of the Interstate between Pennypack Creek and Academy Road, repaired the I-95 southbound ramp to Cottman Avenue, and installed six overhead variable message signs and 16 vehicle detectors for the Traffic Incident Management System.  Under the $84 million project, the 31-span State Road viaduct, the four-span Pennypack Creek crossing, and the northbound and southbound three-span bridges over the Amtrak lines were rehabilitated.  PennDOT removed the northbound and southbound bridges over an abandoned quarry north of Pennypack Creek and replaced them with new roadway.  Construction finished on November 14, 2005.

Also in 2002, the Delaware River Joint Toll Bridge Commission completed the Southerly Crossings Corridor Study, which recommended improvements at the bridge and along the Interstate to relieve current congestion and future congestion and to improve safety.  The study showed that the bridge carries 55,000 vehicles every day and operates at the worst level of service, LOS F, during peak rush hours.  By 2030, traffic is projected to increase an additional 35% to around 74,000 vehicles a day.  Also, within a half mile of the bridge there are two poorly configured interchanges:  Taylorsville Road in Pennsylvania and NJ 29 in New Jersey.  The ramps within these interchanges are not configured properly to safely handle traffic.  In January 2003, the DRJTBC signed a Memorandum of Agreement with PennDOT and NJDOT to continue with environmental studies and preliminary design for improvements to the bridge and surrounding area.  It was an early Christmas present for commuters who use the bridge, when on December 21, 2009, the DRJTBC approved a resolution to advance the planned replacement.  The project will be the largest undertaken by the agency at $328 million, and due to lack of federal and state funding availability, will require tolls to be implemented through a cash-less system involving E-ZPass.  The Commission felt it was more fair to toll the users of the bridge, rather than subject users of the other tolled crossings to foot the bill.  Aside from replacing the current four-lane bridge with a six-lane-wide crossing, the project will upgrade the interchanges at both ends of the bridge, widening I-95 from PA 322 to the bridge, installation of noise walls were needed, and construction of shoulders on the bridge to facilitate breakdowns and emergencies.  The two shoulder lanes will also have the capacity to serve proposed bus/rapid transit routes.  A bike/pedestrian walkway will be installed on the bridge's upstream side to connect canal paths on both sides of the river.  An archeological dig was performed at the site of the new bridge beginning in April 2011 and concluded in July of that year, yielding far less artifacts that originally anticipated.  The contents of the dig were divided between the state museums of both Pennsylvania and New Jersey.  July 2011 also saw the beginning of study by KPMG and Nossaman LLP to evaluate the financial and legal feasibility of using a public/private partnership for the project.  On June 14, 2012, the Federal Highway Administration issued a formal Finding of No Significant Impact (FONSI) on the project's environmental documentation, effectively giving the "green light" to the project.  Project website:  http://www.scudderfallsbridge.com/.

A double-decker Interstate 95 has been discussed, and if Pennsylvania House Speaker John Perzel has his way, it will become a top priority for PennDOT.  In his discussions with Governor Rendell, he has pushed the double-decker proposal for I-95 and I-76, as well as eliminating the two deadliest intersections on Roosevelt Boulevard.  Explaining his vision, Perzel said, "You will pay like a $10 fee.  You'll go up.  You'll be able to go down to the airport and get off at Center City.  It will be quick, and it will be fast."  Rendell said of the projects, "If we had the money, sure.  It would be great."  He added that it would all depend on how much federal highway aid Pennsylvania would receive, and if the Commonwealth received less than expected, none of the projects would get off the ground.  No plans were in effect to raise the gas tax to make up for lack of money from Washington.

Time has been taking its toll on the Girard Point Bridge.  A $7.8 million rehabilitation project began on September 7, 2004 on the 18-span, double-deck bridge that carries traffic over the Schuylkill River.  PennDOT District Executive Andrew L. Warren said the rehabilitation project will prolong the life of the span. "Our inspections have identified certain parts of the bridge that need to be corrected before they become problematic. We’re making these improvements to ensure the Girard Point Bridge continues to provide safe, reliable service to commuters and interstate travelers."  The general contractor, Buckley and Company, Inc. of Philadelphia will repair the bridge's floor beams and other structural steel, replace expansion joints and drainage, patch the bridge decks and walls, replace clogged downspouts and clean drainage inlets, repair and paint isolated areas of corroded steel, clean underground drainage lines, and upgrade the lighting.  Work was completed in Fall 2005.

Morning rush hour was even more unkind to those traveling the Interstate on March 18, 2008, because the night before at 11:50 PM, PennDOT decided to close a three-mile stretch between Girard and Aramingo Avenues.  The reason was due to a crack six-feet-long and two inches wide in a concrete support pillar near the center section of the Interstate at the Richmond Street overpass.  The crack was first discovered by an inspector in October 2007 and the same one just happened to be in the area the day before and checked on the fissure.  It had grown considerably in the five months, which prompted the closure.  Construction of a temporary support system consisting of four steel towers, steel beams, and a two-foot thick foundation began that morning at 7 AM which took the weight off the concrete support so it could be repaired.  Work to make structural repairs at several locations along the Interstate was to begin later this year, and this one was to be repaired under the project with complete reconstruction to start in about five years.  At 6:30 AM on March 20, Interstate 95 was reopened to traffic as were seven on-ramps that were also closed due to the emergency closure.

Construction to improve the Cottman Avenue interchange began in 2009.  The $34 million project involved building two new ramps at Cottman Avenue and rebuilding Cottman and Princeton Avenues, which were converted to two-way streets between Torresdale Avenue and State Road.  Princeton Avenue was rebuilt to include traffic-calming additions, new sidewalks, curb ramps, and bicycle lanes.  The old on-ramp to southbound I-95 from Princeton was removed after the new on-ramp at State Road and Longshore Avenue was opened in August 2011.  State Road was widened to one northbound and two southbound lanes with new storm water drainage systems, new sidewalks, and curbs.  This part of the 95revive project was completed in Summer 2012.

In September 2009, construction began at the Girard Avenue interchange.  The first phase included building a temporary off-ramp adjacent to the southbound off-ramp at Girard Avenue to provide access to Delaware Avenue, reconstructing new lanes to carry northbound Aramingo Avenue on a new alignment between Delaware Avenue and York Street with a spur for access to southbound I-95, drainage improvements, highway lighting, and utility relocation, costing $8.8 million and finished in July 2010.  The second phase began in November 2011 and involved reconstruction and widening of Richmond Street on its existing alignment between Aramingo Avenue and Cumberland Street, reconstruction and widening Richmond Street on a new alignment between Cumberland and Ann streets, improving intersections at Lehigh Avenue and Girard Avenue, bike lanes on Richmond Street, replacing two Conrail bridges over Richmond Street, reconstructing and rehabilitating Girard Avenue bridge over northbound Aramingo Avenue, utility relocation, reconstruction of SEPTA's Route 15 trolley line along Girard Avenue and Richmond Street, and ITS equipment installation along arterial routes near I-95.  This $91.3 million portion will finish in November 2015.  The third phase began in October 2012 and involves widening and reconstructing the Interstate from south of Shackamaxon Street to north of Columbia Avenue, replacing the bridges over Shackamaxon and Marlborough streets and Columbia Avenue, construction of five retaining walls along I-95, noise wall installation, utility relocation, and ITS equipment installation along I-676 and I-95.  Perhaps the most interesting part of this phase was the use of sustainable enhancements to the corridor such as repurposing salvage for public art, low-maintenance landscaping, progressive storm water management devices, LED street and underpass lighting, and decorative treatment of bridge abutment walls.  The $39 million portion will conclude in 2015.

While not on the scale of the 95Revive project, visitors to the Keystone State entering from Delaware received a warmer welcome on October 3, 2011.  A new 8,500-square-foot Welcome Center opened that day, replacing two smaller buildings.  Construction began in May 2010 and the facility had been open to travelers since June 20 while minor work continued.  "This new Welcome Center provides visitors with a warm and friendly place to rest, enjoy a picnic under one of the pavilions or learn about the wonderful tourists locations to visit right here in southeastern Pennsylvania or throughout the commonwealth," said PennDOT’s Deputy Secretary for Administration Mark Compton.

Beginning in August 2012, reconstruction of 1.4 miles of the Interstate between Levick Street and Bleigh Avenue began  Work entailed replacing even structurally deficient bridges on the expressway and widen another, building a new on-ramp to southbound I-95 from PA 73/Cottman Avenue, upgrading four existing ramps, extending Princeton Avenue eastbound to Milnor Street, reconstructing New State Road, building 13 retaining walls, replacing an 84-inch diameter water main and a 10.5-foot-high by 10.5-foot-wide sewer box culvert along Wissinoming Street, and installing storm water drainage pipes and Intelligent Transportation System equipment.  Construction is estimated to be completed in Summer 2017.
